Skip to Content

George Street Upgrade

George Street Upgrade

Media gallery

Project management

Managed by City of Norwood Payneham & St Peters

Design: Landskap, Dryside Engineering, BE Engineering, Enerven, Pavement Asset Services, Geared Engineering

Contractor: Outside Ideas

*Total cost represents a combination of new construction works and asset renewal works that have been aligned to coincide with the timing of the George Street Upgrade.

The George Street Upgrade between The Parade and Webbe Street, Norwood, represents the first stage of implementation of The Parade Masterplan and is a significant and transformational project for the City and the eastern region.

The Project will commence with the construction of new stormwater drainage infrastructure in Harris Street and George Street to address stormwater management in the local area. As such, the stormwater drainage works have been brought forward in order to be completed prior to undertaking the streetscape works.

Following this, the streetscape upgrade will transform the public realm into a better designed, high-quality public space that demonstrates the Council’s commitment to provide safe and vibrant streetscapes, increase green canopy cover, promote a healthy environment and encourage opportunities for social connection.

The George Street Upgrade will benefit residents and visitors through safer, accessible and welcoming spaces, a greener and more visually appealing streetscape and well-lit places to rest and connect with others along Adelaide’s premier main street, The Parade.

Project overview

The prioritisation of pedestrian safety, movement and amenity underpin the purpose of the Project through:

  • widening of pedestrian footpaths
  • street furniture to provide rest areas for pedestrians
  • enhanced lighting for safety and to encourage social activity into the evening hours
  • new street trees and irrigated garden beds to increase canopy cover, cool the local environment and improve the amenity
  • new stormwater drainage in Harris and George Streets to mitigate localised flood risks.

Staged approach to construction

The Council has worked closely with stakeholders to develop and implement a staged approach to construction, minimising impact and disruption to traders and visitors while ensuring an efficient construction timeline.

As the construction progresses, some changes to access arrangements within the immediate precinct will be required. Advance notice will be provided to traders and residents immediately impacted by any changes to access.

Dedicated work zones will be established for each specific area of the construction works to minimise impacts on local residents, traders and visitors as much as possible.

While we endeavour to minimise impacts, construction works will generate some temporary impacts such as noise and dust along with localised alterations and restrictions to access whilst the works are occurring.

Supporting traders and residents during the construction works

The Council and the project team are committed to minimising disruption to traders, residents and visitors to the precinct as much as practically possible.

Our approach to supporting George Street and The Parade business and property owners during construction includes:

Advance communications

We will endeavour to provide traders on George Street and The Parade and surrounding residents with at least 10 days of notice of upcoming work near their business or home. Any changes to the planned work program and access arrangements will be communicated in advance of work starting

  • The project team will continue to provide updates as the project progresses, as well as information about upcoming activities. We will make this available on our website and via social media, and hard copies will be provided to business owners to share with customers.

Wayfinding signage

  • A map clearly showing how to navigate to and around George Street during construction will be available. The map will include vehicle and pedestrian access and parking information. We will make this available on our website and via social media, and hard copies will be provided to businesses to share with their customers. Regular updates will be provided in advance of any changes to access
  • Temporary on-street signage will be located at key entrance points to George Street alerting drivers to any changed traffic conditions. Temporary signage will also highlight safe pathways for pedestrians and bike riders.

Shop front access

  • Contractors working on this project will ensure pedestrian access to shop fronts and businesses on George Street remain available during business trading hours, to the extent that it is practicable and meets safety considerations. This may involve installing temporary ramp access to shop fronts while footpaths are being reconstructed.

Deliveries, loading and waste

  • We will provide George Street and The Parade traders with at least 10 days of notice of any planned access changes that will impact delivery, loading or waste collection arrangements. This will also apply to residents who are impacted by the construction works.

Christmas and New Year trading period

  • Construction will pause over the Christmas trading period from 6 December 2025 to 2 January 2026.

George Street Upgrade Information Pack

Click on the flipbook below to view online or download the PDF version

Ask a question

If you can’t find the answer to your question about the George Street Upgrade and construction works in the FAQ’s below, please submit yours:

Ask a Question form

Timeline

  • Detail design

    October 2024

    Complete

  • Procurement of contractor for works

    March - July 2025

    Complete

  • Construction commences

    September 2025

    Scheduled

  • Construction pause for Christmas

    6 December 2025 - 2 January 2026

    Scheduled

  • Construction complete

    End March 2026

    Scheduled

  • Open to public

    End March 2026

    Scheduled

FAQ's

Why is George Street getting an upgrade?

The George Street Upgrade is the first stage of implementation of The Parade Masterplan.

The Parade Masterplan was endorsed by the Council in 2019. As part of The Parade Masterplan development, a concept design for George Street was developed and presented to the community for consultation.

Following this, feedback was used to further refine the concept design which has since been finalised and endorsed for construction.

For further information on The Parade Masterplan, visit The Parade Masterplan.

What does the George Street Upgrade include?

The upgrade of George Street will convert the existing on-street carparking spaces on both the eastern and western sides of the street into wider pedestrian footpaths with new street trees, garden beds, street furniture and lighting.

This will provide new space, opportunity and purpose to visit, stay and participate in public life and the economic, cultural and civic offerings of The Parade precinct.

When completed, visitors to George Street will see:

  • improved safety for pedestrians

  • improved amenity including shading, greenery and improved public lighting more places for people to rest and connect

  • improved traffic operations and safety

  • improved stormwater drainage.

Can I still access the businesses on George Street during construction?

Yes – pedestrian access to shopfronts will remain available throughout the works. Temporary signage will help guide pedestrians and cyclists safely around any changes. Visitors will still be able to access parking facilities located within the area, which will be supported by additional signage where there are changes in to access these facilities

Did the Council consult with the community?

The Council undertook extensive consultation with the community and key stakeholders to help inform the final concepts and designs for The Parade Masterplan, including the George Street Upgrade Project.

The Parade Masterplan

The Parade Masterplan was developed over a number of phases involving significant engagement and consultation with visitors, residents and businesses, as well as key State Government stakeholders.

  • Stage 1 — Seeking thoughts, feedback and ideas about what people love and want to change about The Parade

  • Stage 2 — Development of key concepts and changes based on the feedback from Stage 1.

  • Stage 3 — Development of a Masterplan that articulates the long-term vision and strategic direction and guides future development of The Parade.

Each of the three stages presented opportunities for community engagement and feedback through a variety of ways including online and in-person surveys and feedback forms, dedicated workshops and information sessions, hosting stalls at community events and targeted engagement with key stakeholders such as trader groups, business owners and operators, residents, schools, visitors and State Government departments and decision makers.

For further information on The Parade Masterplan, visit The Parade Masterplan.

George Street

A key component of The Parade Masterplan consultation activities was the concept design for George Street. Two concepts were presented based on Stage 1 feedback and aspirations for the precinct.

As part of the consultation, participants were asked to select a preferred concept option for George Street. Based on the community’s feedback and aspirations for the street, Option 2 was selected as the basis for the George Street design.

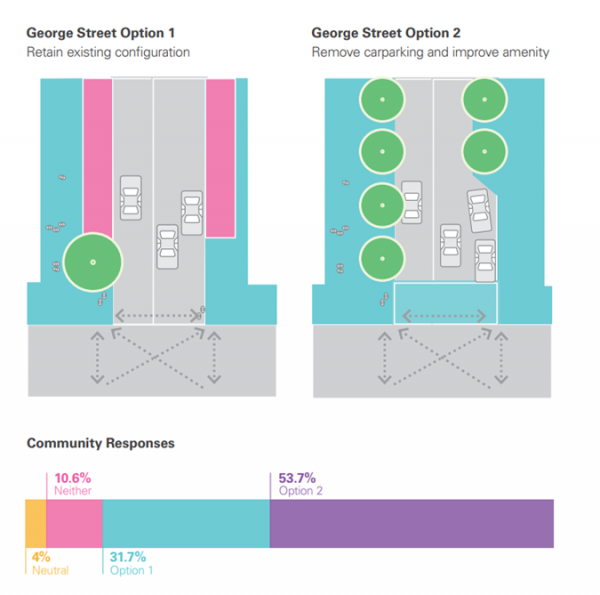

George Street Options: Community Responses

In preparing the detail design for George Street, the Council has also undertaken extensive consultation with key stakeholders to ensure that the design achieves an appropriate balance between providing new opportunities to activate the street which is currently underutilised, improve safety and amenity for people whilst also addressing the access needs for people who visit the area along with operational requirements for businesses.

How is the project being funded?

Funding for the stormwater works to George Street and Harris Street is funded through the Council’s Long-term Stormwater Drainage Program.

Refer to the Council’s Long-term Financial Plan.

What are your mitigations around construction noise and vibration, including out-of-hours works?

We’ll minimise disruption through early and ongoing communication with affected residents and businesses. This includes: • Advance notice of noisy or out-of-hours works, with details on timing, location and noise levels • Regular project updates via newsletters and site signage • Noise and vibration monitoring, where required • Avoiding high-impact works during sensitive times

What type of paving is being used in the upgrade?

Clay brick pavers manufactured in South Australia will be used for the project. As part of the design process, the Council installed samples in George Street to assess the pavers performance including slip resistance, durability and ongoing maintenance requirements.

Will there be more trees added to George Street?

Additional trees will be planted in George Street as part of the upgrade to increase canopy cover, cool the local environment and beautify the streetscape.

A number of tree species will be planted including Jacaranda's which will be used to provide shading on footpaths whilst also providing a splash of colour in the summer months. Jacaranda trees are a native species that have a good track record of performing well in urban settings.

Purple Flowering Jacaranda Trees

Crepe Myrtle trees will also be used where there are building verandahs that are close to the widened footpaths which will limit the amount of space that trees will be able to grow in yet still provide shade whilst not obstructing site lines for people and vehicles. Crepe Myrtles have been used and performed well in many of the small streets within the City of Norwood Payneham & St Peters where space is restricted.

White Flowering Crepe Myrtle Trees

What improvements are being made to street lighting?

New street lighting will be installed over footpaths and the roadway as part of the project. The lighting levels will result in improved safety for pedestrians and visitors.

Additional feature lighting will also be installed to activate the Norwood Concert Hall which is located on George Street.

The Concert Hall is an iconic entertainment destination that, together with the adjacent Hoyts Cinema complex, attracts a diverse range of patrons.

The feature lighting will be flexible and able to be changed to cater for specific events at the Concert Hall and other events that are hosted in The Parade precinct.

Why are stormwater improvements included in the project?

The stormwater works will see new stormwater drainage infrastructure constructed in Harris Street and George Street to address localised flooding issues. The works were identified in the Council’s Long-term Drainage Program and were scheduled to be undertaken in 2035.

These works have been bought forward and integrated into the George Street Upgrade Project to ensure that the risks associated with flooding in and around George Street are addressed now rather than in the future.

Integrating the stormwater drainage works from the Long-term Drainage Program in the George Street Upgrade will also ensure that the Council delivers its assets to the community in an efficient and cost-effective manner.

When will construction commence?

The George Street Upgrade will commence construction in early September 2025. The project team has been working closely with local stakeholders to minimise business and community disruption as much as possible.

How long is the construction expected to take?

The construction works are scheduled to be completed by mid-2026.

Will construction be happening over the Christmas trading period?

Construction will pause over the Christmas trading period from 6 December 2025 to 2 January 2026.

How will the construction works be undertaken?

The construction of the George Street Upgrade will be undertaken in a number of smaller stages.

By staging the project, we are able to maintain access in around the project area as much as possible and construction works can be efficiently undertaken.

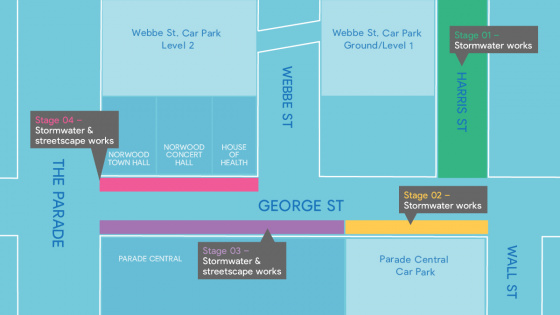

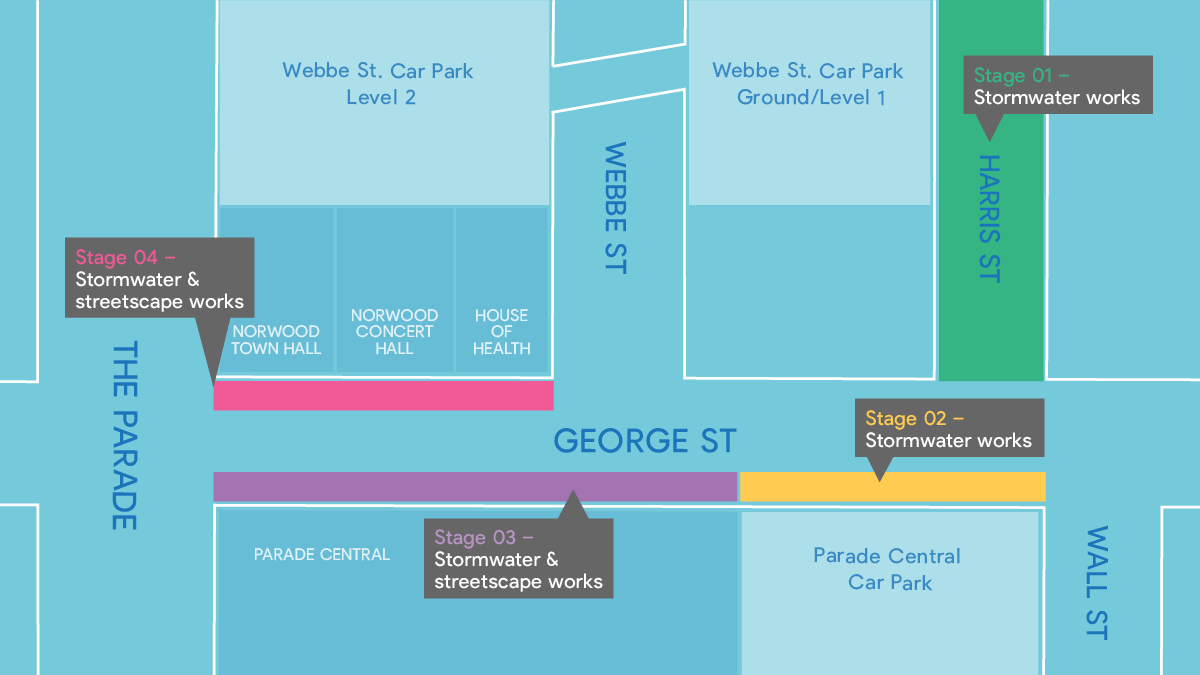

Key stages of the construction will involve:

  • Stormwater drainage works in Harris Street

  • Stormwater drainage works across George Street (to be undertaken at night to minimise disruption)

  • Stormwater drainage and footpath works on George Street between Wall Street and Webbe Street (eastern side)

  • Stormwater drainage and streetscape works on the eastern side of George Street between Webbe Street and The Parade

  • Streetscape works on the western side of George Street between Webbe Street and The Parade

  • Road reseal works on George Street between Webbe Street and The Parade ( to be undertaken at nigh to minimise disruption).

Works Notices

Subscribe for Works Notices

Subscribe to receive updates of upcoming works, including construction dates and traffic detours.

Works Notices Subscribe Form.

Site Address

George Street, Norwood

Cost

$4,190,000*

Project Contact

Contact Stuart Pope

Contact role Project Manager, City Projects

Phone 08 8366 4555

Email georgestreetupgrade@npsp.sa.gov.au
